Bathroom Floor Plans
4x10 Bathroom Floor Plans With Showers
08.26.2026
In This Article
Your 4-foot-wide bathroom has enough length for every fixture you need and still feels tight each time you pass the toilet. These two 4x10 bathroom floor plans protect a usable path from the door to the shower, so daily routines stay comfortable. With 10 feet to divide, the choice comes down to a larger shower or more counter space.
The plans here assume a finished interior measuring 48 by 120 inches between the wall surfaces. A framed 4x10 footprint will be smaller after drywall, backer board, and tile are installed, so confirm what the dimensions represent before using them.
This shape turns up in rowhouse rear extensions, converted closet runs, basement bathrooms along foundation walls, and compact ADUs. The existing plumbing stack, masonry wall, or stair opening often sets the limits for fixture relocation.
Every fixture projects into the same narrow aisle. Five inches saved at the toilet makes a noticeable difference when someone is drying off or helping a child at the sink.
Protect 24 inches for the continuous path through the room when the plan allows. Working to the 21-inch toilet minimum leaves little tolerance for tile thickness or an out-of-plumb wall.
Use the finished dimensions from each fixture’s specification sheet, since labels such as compact and standard cover a wide range of sizes:
| Fixture | Common depth or projection |
|---|---|
| Alcove tub | 30 to 32 inches |
| Standard toilet | 27 to 30 inches |
| Short-projection toilet | 23 to 25 inches |
| Stock vanity | 21 to 22 inches |
| Shallow vanity | 16 to 18 inches |
Reducing toilet projection from 29 to 23 inches increases the clear space from 19 to 25 inches. An 18-inch vanity leaves 30 inches in front, enough to stand squarely at the sink.
Under IRC Section R307, a toilet needs at least 15 inches from its centerline to a side wall or adjacent fixture and 21 inches of clear space in front. The same section calls for 24 inches of clear floor in front of a shower opening.
Shower compartments have separate requirements under IRC Section P2708. The finished interior needs at least 900 square inches, with a 30-inch minimum dimension and a 22-inch clear access opening. Local amendments sometimes require more, so the final drawing needs review under the code adopted where you live.

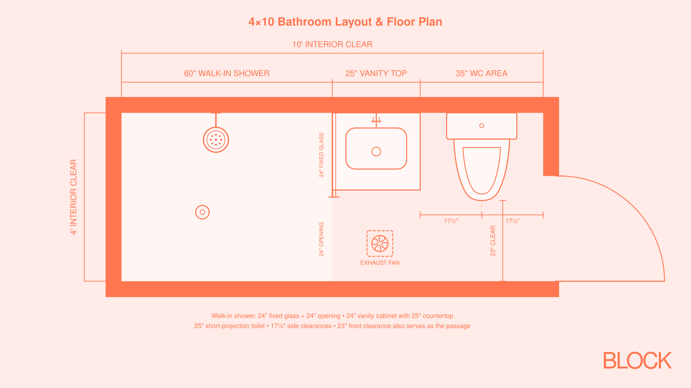

Compared with a 6x8 bathroom, this footprint favors a one-wall sequence with the shower across the far end. The toilet and vanity stay along one long wall, leaving a direct path from the door.

Choose this version when bathing space matters more than storage, especially in a guest bathroom, ADU, or primary bath used by one or two adults. The dry zone fits the essentials as long as the toilet projects no more than 25 inches and the vanity stays around 16 to 18 inches deep. Towels and extra toiletries will need a cabinet outside the bathroom or recessed storage in the wall.

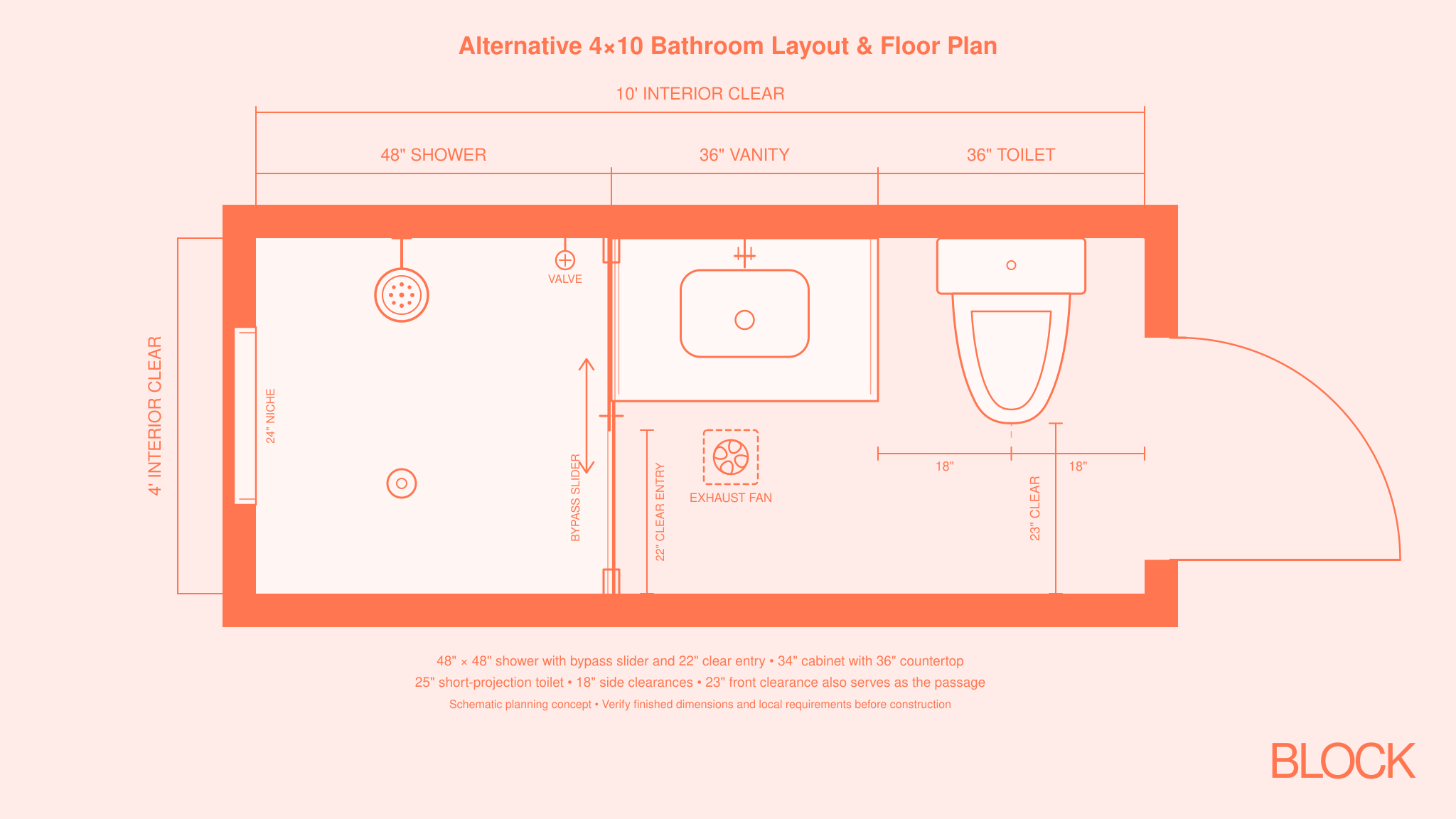

For families renovating the only bathroom in the house, this layout will get more daily use. The shower remains comfortable, and the extra foot supports a longer vanity with drawers and counter space on both sides of the sink. Plan 2 marks a 22-inch clear shower entry, so keep that finished measurement when selecting the glass enclosure and accounting for tile thickness.
The 48-inch shower is the stronger all-purpose choice when towels, bath toys, hair tools, and cleaning supplies must stay in the room. Choose the 60-inch version when storage already exists nearby and the larger shower will get more use than another foot of counter.
A 60-inch alcove tub fits along the 10-foot wall and leaves only 16 to 18 inches between the apron and the opposite wall. That passage feels cramped once a bath mat is down or someone is helping a child climb out.
A compact soaking tub around 48 to 54 inches long and 27 to 28 inches deep returns a few inches. Check the interior bathing well too, since short tubs vary greatly inside.
Still, the only bathroom in the house deserves special consideration. For many families with young children, the tub is part of the nightly routine, and future buyers may expect at least one in the home. Think about your routine and ask a local real estate agent how buyers respond to shower-only homes in your area, a concern shared by many long, narrow bathroom layouts.
Show the entry door and shower door open at 90 degrees on the same plan. That view catches overlapping swings before the framing and plumbing locations are final.
IRC rules require a hinged shower door to open outward, placing its swing in the aisle. A fixed panel or sliding enclosure avoids that conflict.
Some sliders advertised for a 48-inch opening have a smaller walk-through after the panels overlap. Plan 2 marks the required 22 inches, so confirm that installed clearance on the enclosure specification sheet.
Open shower entries depend on the floor pitch, glass length, and showerhead position. Aim the showerhead away from the opening and pitch the floor toward the drain.
Start with the shower-floor tile. Mosaics follow the multiple slopes around a point drain, and larger tile needs the single-plane pitch created by a linear drain at the back wall. In either assembly, proper pitch and waterproofing determine how well the shower drains.
Depending on the structure, curbless construction requires a recessed subfloor, modified joists, concrete work, or a raised bathroom floor. A low curb costs less when recessing the shower becomes difficult. Removing the threshold reduces a trip point. Full wheelchair access still requires more turning space than this room has.
Design a Home That’s Uniquely Yours
Block can help you achieve your renovation goals and bring your dream remodel to life with price assurance and expert support.
Get Started
Freestanding shelves narrow the passage and collect clutter where you already have little room to spare. Built-in and wall-mounted storage keeps the floor open.
IRC Section M1505.4.4 calls for 50 CFM of intermittent exhaust or 20 CFM of continuous exhaust. Long ducts, several elbows, or a tall ceiling justify considering 80 CFM. A 110-CFM default is excessive for 40 square feet, so choose a quiet fan close to the shower. A timer or humidity sensor keeps it running after the shower ends, and tile installed from floor to ceiling protects the wettest walls.
Place sconces beside the mirror or choose a well-designed illuminated mirror. Light at face level is more useful for shaving, makeup, and skin care than a ceiling fixture behind your head.
Rectangular floor tile laid along the 10-foot axis draws attention through the room instead of across its narrow width. Check the cut pattern at the walls and shower before committing, since clean edges matter more than the direction alone.
A small bathroom still requires a plumber, electrician, tile installer, painter, and often a glass fabricator. Their setup time does not shrink with the floor area, so a 4x10 remodel costs close to a 5x8 renovation with a similar scope. Labor accounts for 60% to 70% of the total in many compact bathrooms involving several skilled trades.
These are representative planning ranges. Local labor, access, permits, hidden damage, and finishes move the total, so ask each contractor whether demolition, debris removal, waterproofing, glass, painting, and permits are included.
Budget another $2,500 to $6,000 for a curbless conversion, depending on the floor structure. A linear drain adds $800 to $2,000 in material and installation. Include the entire assembly when comparing shower installation costs.
Moving a toilet costs far more than moving a sink when the larger waste line crosses the joists or travels farther from the stack. In some homes, rerouting the plumbing requires opening the ceiling below. Compact stock fixtures do not automatically carry a premium. Cabinetry made to a nonstandard depth costs more.
In a 4x10 bathroom, a missed dimension can affect several fixtures, so detailed scopes matter. Tell Block your renovation details once, and vetted local contractors matched to your project can compete for the work with quotes based on the same expectations.
You can compare the scopes side by side and get an upfront review to identify missing line items and red flags before construction. Block uses a secure payment system that releases funds as the project progresses, and every contractor in the network carries a one-year workmanship warranty.
Remodel with confidence through Block
Connect to vetted local contractors
We only work with top-tier, thoroughly vetted contractors
Get expert guidance
Our project planners offer expert advice, scope review, and ongoing support as needed
Enjoy peace of mind throughout your renovation
Secure payment system puts you in control and protects your remodel
Is 4 feet wide enough for a full bathroom?
How large can a shower be in a 4x10 bathroom?
Can a 4x10 bathroom include a tub?
Does a 4x10 bathroom need a pocket door?
Written by David Rudin
David Rudin
Renovate confidently with Block
Easily compare quotes from top quality contractors, and get peace of mind with warranty & price protections.
Thousands of homeowners have renovated with Block
4.5 Stars (100+)
4.7 Stars (100+)
4.5 Stars (75+)
Bathroom Floor Plans
4x10 Bathroom Floor Plans With Showers
08.26.2026
Bathroom Floor Plans
Bathroom With 2 Doors: Layout Ideas That Work
08.24.2026
Bathroom Floor Plans
Single Wall Bathroom Layout: Pros, Cons, and Tips
07.22.2026
Bathroom Floor Plans
Long, Narrow Bathroom Floor Plans: Layouts That Work
07.21.2026
Bathroom Floor Plans
Square Bathroom Floor Plans & Layout Tips
07.18.2026
Renovate confidently
