Crawl Space to Basement Conversion: What to Know Before You Dig

An unfinished residential crawlspace with exposed wooden floor joists, insulation, various pipes and ductwork, and a dirt floor partially covered by a plastic vapor barrier.

In This Article

    Converting a crawl space into a full basement adds usable square footage without changing your home's footprint. Plan for $50 to $150 per square foot, 4 to 6 months of construction, and a house you may not be able to occupy for much of that time. It is one of the most invasive projects in residential construction: the foundation comes out in sections, the house rests on temporary supports, and much of the digging happens by hand.

    What a crawl space to basement conversion involves

    A conversion digs out the shallow space under your home, typically 1 to 3 feet tall, and replaces it with a full-height basement. This differs from finishing an existing basement, which works within a structure that already exists. A conversion builds that structure from scratch, underneath a house that stays standing the entire time.

    Plan for $60,000 to $150,000 for most projects. Complex conditions can push totals past $200,000. These are planning ranges, and your foundation type, soil, and access will move the number significantly.

    For most conversions, especially those involving underpinning, utility disruption, and temporary structural support, you should plan as if the house will be uninhabitable for part or all of the project. The dig-out alone often runs 3 to 4 months, so budget 4 to 6 months of alternative housing alongside the construction cost. Most cost guides bury this line item.

    The project makes the most sense when you cannot build out or up. Tight lots, setback rules, and height restrictions are why conversions are common in dense markets like Brooklyn, Jersey City, and Philadelphia.

    How a conversion compares to the alternatives

    Option

    Planning range

    What you get

    Crawl space to basement conversion

    $60,000 to $150,000+

    New full-height level, no footprint change

    Expanding a partial basement

    $20,000 to $80,000

    More space using existing plumbing and electrical

    Finishing an existing basement

    $20,000 to $60,000

    Upgraded finishes in structure that already exists

    Ground-level addition

    Varies by market

    New space, but requires lot room and zoning headroom

    Is your house a good candidate

    Two houses that look identical from the street can receive wildly different conversion quotes, because the cost drivers sit below grade where nobody can see them.

    Better candidate

    Riskier candidate

    Tight lot with no room to build out

    High water table or active seepage

    High-value market where square footage matters

    Neighboring foundations near or below the proposed dig depth

    Clear access for equipment and soil removal

    Rock, expansive clay, or contamination

    Long-term owner who can absorb the disruption

    Owner counting on fast resale ROI

    • Foundation type drives the engineering. Homes on spread footings often require phased excavation and more temporary support than homes on caissons or piers. Brick, block, poured concrete, and stone foundations each demand a different underpinning approach, and older masonry adds shoring requirements.
    • Soil and water conditions set the difficulty. Expansive clay, a high water table, or rock near the surface all change excavation methods and cost. A geotechnical assessment early in planning prevents expensive surprises later.
    • Access determines how much work happens by hand. A tight side yard that blocks equipment means more labor hours moving the same amount of dirt. Urban rowhouses sit at the difficult end of this spectrum.
    • Your neighbor's foundation becomes your concern. Digging below the depth of an adjacent structure's footing can undermine it, and building codes put protection obligations on the excavating party. In New York City, projects that require access to adjoining property under Building Code section 3309 require written notice at least 60 calendar days before work begins, and excavation near neighboring buildings triggers mandatory monitoring. New York courts have also treated certain excavation-related code violations as creating strict liability for damage to adjoining property, so rowhouse and party wall conditions warrant both engineering and legal review before the dig.
    • Older homes need asbestos testing first. Insulation, pipe wrap, and old vapor barriers in the crawl space may contain asbestos, and testing before demolition protects both the schedule and the crew.

    The real starting point is a structural engineer digging test pits to expose your existing footings, not a contractor's ballpark quote. Footing depth, soil bearing capacity, and foundation condition determine everything that follows.

    Who you need on the team

    A typical conversion involves a structural engineer, a geotechnical engineer or soil testing service, an architect or designer, a foundation contractor with underpinning experience, a waterproofing specialist, a plumber, an electrician, and an HVAC contractor, often coordinated by a general contractor. In stricter jurisdictions, a permit expeditor is worth the fee. If a bid names only a GC and leaves the engineering unassigned, ask who is doing that work before comparing prices.

    Set the design targets before anyone digs

    Decisions below the slab are cheap to make during construction and expensive to revisit once the concrete cures. Lock these in before excavation starts.

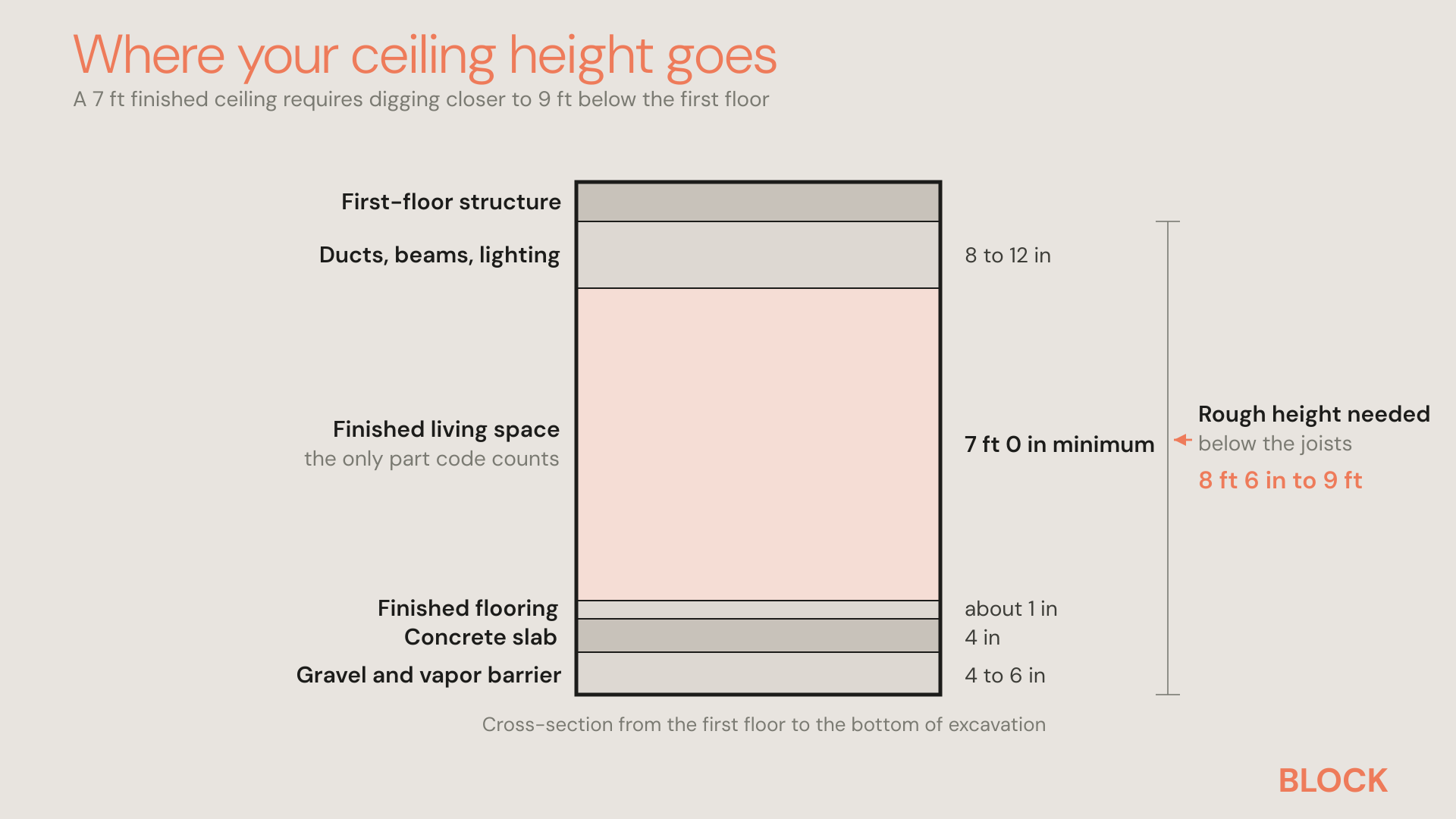

    Dig depth decides whether it feels like a basement

    crawlspace-ceiling-height-stack-crawlspace-basement

    Code generally requires 7 feet of finished ceiling height for habitable space under the International Residential Code, subject to local amendments. The naive math undershoots that target because the slab, finished flooring, ductwork, and beams steal 6 to 12 inches somewhere. If the engineer and budget allow it, pricing an 8.5 to 9 foot rough height during initial planning beats trying to gain height later. The incremental cost is not automatic, since deeper excavation affects underpinning depth, drainage, soil volume, and stair geometry, but it is the difference between a basement and another floor of the house.

    Place the stairs deliberately

    A crawl space has no stairs, which means no inherited stair location. That is rare in renovation. Where the stair lands determines circulation, which zones can become legal bedrooms, and whether the basement connects to the home or feels like an afterthought. A wider stair with a landing does more for the finished result than most upgrade-tier finishes.

    Rough in plumbing under the slab

    Underslab drainage for a bathroom, laundry hookup, or wet bar costs little during the pour and thousands after the concrete cures. If the new floor sits below your sewer line, the ejector pit location also needs to be settled before the pour. A phase-two bathroom should still get phase-one pipes.

    Buy natural light while the excavator is on site

    The basement itself generally requires an emergency escape opening under residential code, and every sleeping room needs its own. If below-grade egress windows are part of the plan, do not treat the wells as bare code boxes. Oversizing them beyond the 9 square foot minimum, terracing them, or planting them brings meaningful daylight into the space instead of just satisfying an inspector. On sloped lots, evaluate a walkout entrance early, because it changes the resale math for the entire project.

    Park the mechanicals in the dead zones

    The furnace, water heater, ejector pump, and electrical panel need a mechanical room with service clearances. Placing it against the darkest wall preserves the window wall for living space.

    Answer the ADU question now

    If a rental unit or in-law suite is even a maybe, it drives the excavation plan. A separate exterior entrance is an excavation-phase feature, and a legal unit typically needs kitchen rough-ins, egress in each sleeping room, and sometimes separate utilities. Requirements vary widely, so confirm what your jurisdiction requires for a legal unit before finalizing the dig.

    How the crawlspace conversion actually happens

    Understanding the construction sequence makes the cost make sense. Each phase involves specialized labor working in order, and none of it can be rushed.

    Support and excavation

    Contractors either raise the house, often $3,100 to $9,400, or brace its footings, which can run up to $20,000. Then the digging starts, and much of it happens by hand. Excavators cannot fit under a standing house, so crews often work with two people and a wheelbarrow at a time, removing dirt for weeks before the next phase can begin. This is why labor dominates the budget.

    Underpinning in alternating sections

    New, deeper footings go in using the pit method: the foundation is divided into sections of 3 to 4 feet, and crews excavate and pour only alternating sections so the house never loses support along a full wall. Most full-perimeter jobs take 5 to 7 sequences, and the underpinning phase alone typically runs 8 to 12 weeks. The slow pace is what keeps the house supported, so treat it as part of the engineering rather than a scheduling problem. The Journal of Light Construction's underpinning guide shows how engineers sequence and number each section before work begins.

    The soil has to go somewhere

    A 1,000 square foot dig going down 5 to 6 feet produces more than 200 cubic yards of soil. That is 20 or more truckloads, plus disposal fees, and sometimes contamination testing before a facility will accept it. Budget for soil removal as its own line item.

    Foundation, waterproofing, and cure

    New footings, walls, and slab go in next, along with the water management system: an interior perimeter drain, a sump pump with battery backup, and a vapor barrier under the slab. Waterproofing should be designed around your water table, soil, grading, and gutter drainage rather than picked from a product sheet, because moisture is the most common failure point in basement work. This is the moment to overbuild drainage, since retrofitting it later means demolishing the floor. Concrete needs to cure across the pour sequences, which creates stretches of weeks where nothing visible happens. Expect those quiet periods and build them into the schedule.

    Finishing

    Once the structure is complete, the project becomes a standard basement build-out: framing, insulation, electrical, HVAC, drywall, and flooring. Finishing typically adds $15,000 to $46,000 depending on scope and materials.

    Budgeting for the whole project

    The headline range hides a stack of individual costs. Plan around these line items:

    Line item

    Planning range

    Excavation and dig-out

    $15,000 to $40,000

    House raising or bracing

    $3,100 to $20,000

    Structural engineer

    $2,000 to $5,000

    Permits and inspections

    $2,000 to $5,000

    Plumbing rerouting

    $3,000 to $7,000

    Demolition and prep

    $1,000 to $4,000

    General contractor fee

    10% to 20% of project total

    Interior finishing

    $15,000 to $46,000

    Three costs hide outside the contract:

    • Temporary housing. Four to six months of rent or extended-stay costs sit on top of every number above.
    • Underground surprises. Boulders, old cisterns, buried previous foundations, and unmapped utilities are common finds, and contracts typically handle them as change orders. Treat any fixed price as a starting point.
    • Soil disposal and testing. Hauling and tipping fees scale with volume, and contaminated soil costs more to place.

    One warning sign deserves its own mention: a bid that comes in far below the others. Crawl space conversions are structural, high-risk projects where experience matters, and a low number on paper often reflects missing scope rather than efficiency. Before signing, ask every bidder:

    • How many crawl space to basement conversions have you completed?
    • Will a structural engineer stamp the underpinning sequence?
    • Who is responsible for adjoining-property protection and monitoring?
    • Does the bid include soil hauling, disposal, and testing?
    • Does the waterproofing scope cover perimeter drains, sump backup, and vapor barrier?
    • What conditions trigger change orders, and how are they priced?

    Before committing to the project at all, price the alternatives in the comparison table above. Expanding a partial basement or building an addition may deliver more usable space per dollar depending on your lot.

    crawlspace-conversion-cost-breakdown

    What a crawlspace-to-basement conversion can be worth

    A well-executed conversion can recoup 50 to 75% of its cost at resale, and it adds finished square footage without changing your home's footprint, which matters in markets where lot coverage is maxed out. The return math differs from a standard basement remodel, though, because the investment is several times larger. The strongest case for conversion is a home you plan to stay in, on a lot with nowhere else to grow: a Brooklyn rowhouse owner who needs a third bedroom, for example, often has no other structural option.

    Remodel with confidence through Block

    Happy contractor doing an interview

    Connect to vetted local contractors

    We only work with top-tier, thoroughly vetted contractors

    Couple planning their renovation around the Block dashboard

    Get expert guidance

    Our project planners offer expert advice, scope review, and ongoing support as needed

    Familty enjoying coffee in their newly renovated modern ktchen

    Enjoy peace of mind throughout your renovation

    Secure payment system puts you in control and protects your remodel

    Get Started

    Frequently asked questions

    Is converting a crawl space to a basement worth it?

    It depends on your market and timeline. In high-value areas where you cannot build out or up, the added square footage often justifies the cost for long-term owners. For owners planning to sell within a few years, the 50 to 75% cost recoup usually argues against it.

    How long does a crawl space to basement conversion take?

    Plan for 4 to 6 months of construction. The dig-out and underpinning phases consume most of the schedule, and concrete cure time between pour sequences cannot be compressed.

    Do you have to lift the house?

    Not always. Contractors either raise the house or brace its existing footings while excavation proceeds. The structural engineer determines which approach fits your foundation, and bracing is common when raising is impractical.

    How deep do you need to dig?

    Deep enough for at least 7 feet of finished ceiling height in most jurisdictions, plus the thickness of the slab, flooring, and any overhead mechanicals. Many projects dig 12 or more inches past the naive target to protect finished headroom.

    Can I live in my house during the project?

    Plan as if you cannot. The foundation is removed in phases while the house sits on temporary supports, and most contractors require the home to be vacant for the structural phases. Budget for alternative housing.

    Can you convert a crawl space yourself?

    The structural work cannot be DIY. Excavating below a foundation without an engineered sequence risks collapse. Homeowners sometimes handle demolition prep or late-stage finishes, but the dig, underpinning, and concrete work belong to licensed professionals.

    Does the new basement need egress windows?

    Yes, in most jurisdictions. Residential code generally requires an emergency escape opening in the basement, and each sleeping room needs its own compliant window or door with a minimum 5.7 square foot clear opening.
