Home Renovation Timeline: Every Phase From Planning to Final Walkthrough

Discover the full stages and timelines of home renovation. Our comprehensive guide helps you plan your project efficiently and avoid common pitfalls.
General contractor hammering a nail during a home renovation

In This Article

    Your contractor says the job will take 8 weeks, but the project still takes 6 months of your life. The gap comes from everything that happens before demolition: budgeting, design, permits, and material orders all sit on the home renovation timeline too, and most estimates only count the construction at the end of it. Mapping all 15 phases, with realistic durations for each, tells you when to order materials, when to book a place to stay, and when you'll actually move back in.

    The phase-by-phase breakdown below covers the full arc of a renovation across its 4 core stages: planning, design, pre-construction, and construction.

    Home renovation timeline by project type

    Every project moves through the same phases, but the total duration varies widely by scope. The ranges below reflect typical start-to-finish timelines, including planning and permitting, not just construction.

    Project type

    Typical total timeline

    Construction portion

    Bathroom remodel

    3 to 6 months

    4 to 12 weeks

    Kitchen remodel

    4 to 8 months

    6 to 12 weeks

    Basement finish

    3 to 6 months

    4 to 8 weeks

    Home addition

    6 to 12 months

    12 to 20 weeks

    Whole-home renovation

    8 to 16 months

    4 to 9 months

    Treat these as planning ranges, and notice what the two columns reveal: the construction portion is the smaller half of almost every project. The construction estimate is the number homeowners plan their lives around, and it's the least useful one on the schedule. Permits alone can take up to 3 months, materials 1 to 3 months, and contractor lead time 1 to 4 months, so the phases in front of demolition often outlast the build itself and belong on your calendar from day one.

    Compare Proposals with Ease

    Easily compare contractor quotes with intuitive layouts, and side-by-side comparisons to help you make the best choice.
    Get a Quote

    What are the key factors that influence renovation timelines?

    Estimating timelines and renovation costs is tricky because each renovation has its own quirks. The more completely you capture your project up front, the more accurate your estimates will be. These factors carry the most weight.

    Project scope

    Are you adding a new coat of paint or reworking the purpose of an entire room? More extensive renovations that involve structural changes and electrical work take much longer than cosmetic refreshes. You'll also lose time if you change the scope mid-project, which is why careful upfront planning matters so much in a remodel.

    Permits and inspections

    Permit review times depend entirely on your local building department, and they range from same-day approvals to multi-month waits. In practice, a slow permit office costs you more time than a slow contractor, since a crew running behind loses you weeks while a stalled application can lose you a full season, and outside of markets where permit expediters operate, there's no paying to jump the line. Check your building department's published review times before you set any move-back-in date. Inspections add scheduling dependencies during construction too, since certain work can't continue until an inspector signs off on the stage before it.

    Unexpected structural issues

    Once walls open up, crews sometimes find problems that have to be resolved before work continues: rot from water damage, black mold, or outdated wiring. Fixing these can require revised plans and, in some cases, additional permits.

    Contractor availability

    Summer tends to be peak renovation season, so the best contractors book up and scheduling delays follow. Starting your search early, or scheduling your renovation for the winter off-season, helps you avoid the queue.

    Weather conditions

    Extreme heat, storms, and poor air quality can slow or pause construction, especially for exterior work like roofing and additions. Every season carries its own risks, so build weather slack into any timeline that includes outdoor work.

    Supply chain and material lead times

    Custom cabinetry, imported tile, and specialty fixtures can take 8 to 12 weeks or more to arrive. Ordering everything before demolition, and sourcing locally where you can, keeps material delays from stalling the build.

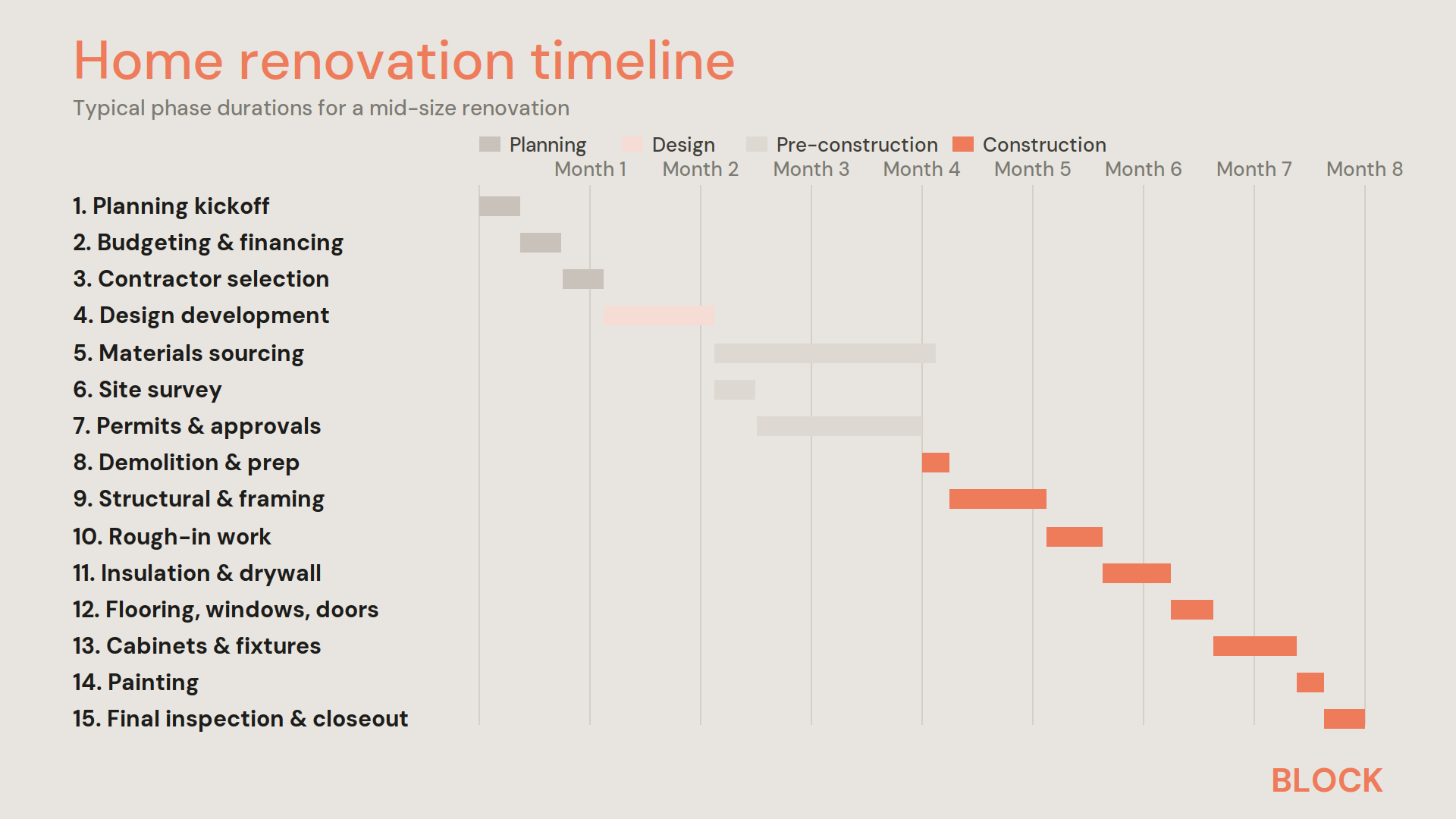

    Home renovation timeline diagram

    The 15 phases of a home renovation and how long each takes

    There are 4 overarching phases to every home renovation: planning, design, pre-construction, and construction. The 15 granular phases below show how those stages break down and how long each one typically runs.

    1. Planning kickoff

    • Purpose: The planning kickoff phase lays the groundwork for your renovation project.
    • Tasks: Gather inspiration, outline your goals, and define the project scope.
    • Timeline estimate: 1 to 2 weeks

    2. Budgeting and financing

    • Purpose: The budgeting and financing phase makes every later step possible.
    • Tasks: Create a budget for all renovation expenses, set aside 10 to 20% as contingency, and decide how you'll finance the project (a loan, savings, or a combination).
    • Timeline estimate: 1 to 2 weeks

    3. Contractor selection

    • Purpose: This phase is when you assemble the team who will build the project.
    • Tasks: Compare at least 3 quotes line by line, and work with a Block Project Planner for support in making the decision. Your team might include a general contractor, designers, or a combined design-build firm.
    • Timeline estimate: 1 to 2 weeks

    Timelines and pricing dominate most contractor interviews, but HRP general contractor Andre Taouil points homeowners to a protection almost nobody asks about:

    "Ask the contractor for a certificate of insurance naming you as an additional insured, covering both workers' compensation and general liability. It comes directly from their insurance agent, not the contractor, and it confirms anyone working at your home is covered if something goes wrong."

    Once you sign with a general contractor, expect lead time between the contract and the start of work. Depending on season and local demand, 1 to 4 months is common. Fold that gap into your timeline from the start.

    4. Design development

    • Purpose: Your renovation takes shape in collaboration with architects or interior designers.
    • Tasks: Develop detailed design plans, including architectural drawings if applicable, and finalize the project plan through rounds of feedback and revision.
    • Timeline estimate: 2 to 6 weeks

    5. Materials sourcing

    • Purpose: This phase covers everything your crew needs on site before demolition.
    • Tasks: Finalize materials, finishes, and fixtures with your designers and contractor, then place orders. Long-lead items like custom cabinets should go in first.
    • Timeline estimate: 1 to 3 months

    6. Pre-construction site survey

    • Purpose: A site survey gives your construction team a clear picture of the space they'll be working with.
    • Tasks: Schedule a walkthrough with your contractor so they can assess current conditions. Any issues with structural integrity, plumbing, or mold get identified now and folded into the scope.
    • Timeline estimate: 1 to 2 weeks

    7. Permits and approvals

    • Purpose: This phase covers everything you're legally required to complete before work begins.
    • Tasks: Check your local rules on home renovation permits, submit applications, and schedule required inspections.
    • Timeline estimate: 2 weeks to 3 months

    Spending real time on these first 7 phases pays off later. The more thoroughly you plan and communicate with the experts you hire, the fewer surprises you'll face once construction begins.

    8. Demolition and pre-construction prep

    • Purpose: Demolition clears the way for construction to begin.
    • Tasks: Demolish what's being replaced, resolve issues uncovered during inspection (like mold removal), and protect the parts of your home that aren't being renovated.
    • Timeline estimate: 1 week

    Where will you stay during your renovation? Before crews break ground, sort out your living situation. If the project isn't contained to an area you can avoid, budget and plan for staying somewhere else for the duration. Get ideas for where to stay during your renovation.

    9. Structural and framing work

    • Purpose: Framing establishes a sound structure for the remodel.
    • Tasks: Your contractor makes any adjustments to the structural framework of the site. Altering load-bearing walls or building new structures lengthens the timeline.
    • Timeline estimate: 1 to 8 weeks

    10. Electrical, plumbing, and mechanical rough-in

    • Purpose: Rough-in work puts the home's working systems in place before the walls close. "Rough-in" refers to running wiring, pipes, and ductwork inside open walls, floors, and ceilings.
    • Tasks: Licensed subcontractors adjust or extend your home's electrical, plumbing, and mechanical systems, followed by rough-in inspections.
    • Timeline estimate: 1 to 3 weeks

    11. Insulation and drywall installation

    • Purpose: Insulation and drywall close up the walls and turn the framed space back into rooms.
    • Tasks: Crews insulate, hang drywall, then tape, mud, and sand until surfaces are ready for paint.
    • Timeline estimate: 1 to 4 weeks

    All of these timelines are general estimates. Your actual schedule depends on factors unique to your project, so pad each phase rather than planning to the exact week.

    12. Flooring, windows, and doors installation

    • Purpose: This phase completes the perimeter and surfaces of the renovation.
    • Tasks: Your team installs flooring (resolving any subfloor issues first), windows, and doors according to plan.
    • Timeline estimate: 1 to 2 weeks

    13. Cabinets, countertops, and fixtures installation

    • Purpose: The space's major installations happen here.
    • Tasks: Crews install cabinetry, countertops, plumbing fixtures, appliances, and lighting.
    • Timeline estimate: 2 to 4 weeks

    14. Painting

    • Purpose: Paint finishes the surfaces and ties the space together.
    • Tasks: Your team paints walls, ceilings, and trim to plan.
    • Timeline estimate: 1 week

    15. Final inspection and closeout

    • Purpose: Closeout confirms the work is complete, compliant, and documented before you move back in.
    • Tasks: Complete the punch list, pass final inspections, do the final walkthrough, release final payment, and collect warranty paperwork. The section below walks through each step.
    • Timeline estimate: 1 to 2 weeks

    The final stages of a renovation project

    The last 2 weeks of a renovation involve more than cleanup. Closeout is where you confirm the work matches the contract, the city signs off, your final payment stays protected, and your warranty coverage gets documented. Here's what happens, in order.

    Punch list

    A punch list is the running record of small items that still need attention: a door that sticks, a missed paint touch-up, a cabinet pull installed crooked. Walk the space with your contractor, write down every item together, and agree on a completion date. Nothing on the list should be left to memory or a verbal promise.

    Final inspections

    If your project required permits, the building department performs final inspections before the work is officially approved. Depending on scope, that can include electrical, plumbing, and building inspections, and for larger projects, a certificate of occupancy or certificate of completion. Keep copies of every sign-off. You'll want them when you sell, refinance, or file an insurance claim.

    Final walkthrough

    The final walkthrough is your last structured review with the contractor before releasing final payment. Test everything: run water at each fixture, flip the light switches, open the doors and drawers, and check finishes in daylight. Anything that fails goes back on the punch list before payment moves.

    Final payment and lien waivers

    Release the last payment only after the punch list is complete and inspections have passed. Collect a final lien waiver from your contractor, which is a signed document confirming that the contractor and their subcontractors have been paid and waive any claim against your property. Taouil recommends structuring the contract so final payment is roughly 10% of the total, held until the waivers are in hand, and adjusting that figure to fit your project. Without the paperwork, you could pay your contractor in full and still face a lien from a subcontractor they never paid. Progress-based payment systems, like the one Block manages, hold this leverage in place automatically by tying each release to completed milestones.

    Warranty and documentation handoff

    Before the crew leaves for good, collect the paperwork you'll rely on later:

    • Workmanship warranty terms. Every contractor in the Block network provides a 1-year workmanship warranty, and you should confirm the terms of yours in writing regardless of who you hire.
    • Manufacturer warranties and manuals. Appliances, windows, fixtures, and mechanical equipment each carry their own coverage, and registration often has a deadline.
    • Paint colors, tile lots, and material spec sheets make future repairs and touch-ups far easier to match.

    Site cleanup and move-in

    Construction cleaning goes beyond a normal deep clean: fine drywall dust settles into HVAC systems, cabinet interiors, and window tracks. Confirm whether professional post-construction cleaning is in your contract scope, then schedule your move back in once it's done.

    Map your home renovation timeline with Block Renovation

    A realistic timeline comes from planning every phase, not just the construction weeks. Give the early phases the time they need, pad the estimates, and keep your closeout checklist as firm as your design plan.

    You don't have to build that timeline alone. Block's renovation platform matches you with vetted contractors based on your project, lets you compare detailed quotes side by side, and ties payments to progress so your schedule and your money stay aligned. Get a free consultation to map out a timeline that works for your home.

    Remodel with confidence through Block

    Happy contractor doing an interview

    Connect to vetted local contractors

    We only work with top-tier, thoroughly vetted contractors

    Couple planning their renovation around the Block dashboard

    Get expert guidance

    Our project planners offer expert advice, scope review, and ongoing support as needed

    Familty enjoying coffee in their newly renovated modern ktchen

    Enjoy peace of mind throughout your renovation

    Secure payment system puts you in control and protects your remodel

    Get Started

    Frequently asked questions

    How long does a full home renovation take?

    A whole-home renovation typically takes 8 to 16 months from planning kickoff to final walkthrough, with 4 to 9 of those months in active construction. Scope, permitting speed, and material lead times drive where a project lands in that range. Single-room projects like bathrooms and kitchens usually finish in 3 to 8 months total.

    What are the main phases of a home renovation?

    Every renovation moves through 4 core phases: planning, design, pre-construction, and construction. Planning covers goals, budget, and contractor selection. Design produces the detailed plans, pre-construction covers permits, surveys, and material orders, and construction runs from demolition through final inspection.

    What comes first in a home renovation?

    Planning comes first: define your scope, set a budget with a 10 to 20% contingency, and select your contractor before any design or construction work begins. Changing scope after work starts is one of the most common causes of delays and cost overruns, so decisions made in this phase protect the entire timeline.

    What are the final stages of a renovation project?

    The final stages are the punch list, final inspections, the final walkthrough, final payment with lien waivers, warranty and documentation handoff, and post-construction cleaning. Together they typically take 1 to 2 weeks. Release final payment only after the punch list is complete and required inspections have passed.

    Why do renovations take longer than the construction estimate?

    Construction estimates usually cover only the build itself, not the months of planning, design, permitting, and material lead time that come first. Permits alone can take 2 weeks to 3 months, and custom materials often need 8 to 12 weeks to arrive. Counting every phase from the start gives you a timeline you can actually plan around.
