You step over the same tub wall every morning to take a shower, and the tub itself gets filled maybe twice a year. That mismatch is why a bathroom remodel from tub to shower is one of the most requested renovations there is, and it is also why the quotes come back so far apart, anywhere from $3,500 for a prefabricated conversion to $20,000 for a curbless tiled build. Most of that gap comes from how much plumbing has to move.
There are two versions of this project. A standalone tub-to-shower conversion leaves the rest of the bathroom alone, so the shower is the whole job. The other version folds it into a full bathroom remodel, where the conversion becomes one line item alongside the floor, the vanity, and the toilet. Most of the price confusion online comes from quoting a single number for both.
For finished examples across a range of budgets, see before and after tub to walk-in shower conversions.

Count the tubs in your house before this goes any further. A National Association of Home Builders survey found 74% of buyers want both a tub and a shower in the primary bathroom, and conversions hold their value best when a tub stays somewhere in the house. Removing the only one narrows your buyer pool, particularly among families with small children. Price that into the decision if you expect to sell within a few years.
A drop-in tub in a tiled platform is a different job from an alcove tub with three walls already around it, and the estimate shows it.
Every number below is a planning range built on scope. Where you fall inside one depends on your market, your building, and how far the plumbing travels.
| Scope | What it includes | Planning range |
|---|---|---|
| Basic conversion | Prefabricated base, panel walls, framed slider, plumbing stays put | $3,500 to $6,500 |
| Tiled conversion | Tiled walls, prefabricated or tiled pan, drain relocated within the alcove, semi-frameless glass | $6,500 to $12,000 |
| Custom build | Curbless or linear drain, full tile, frameless glass, niche and bench | $12,000 to $20,000 |
A few things shift the total at every tier:

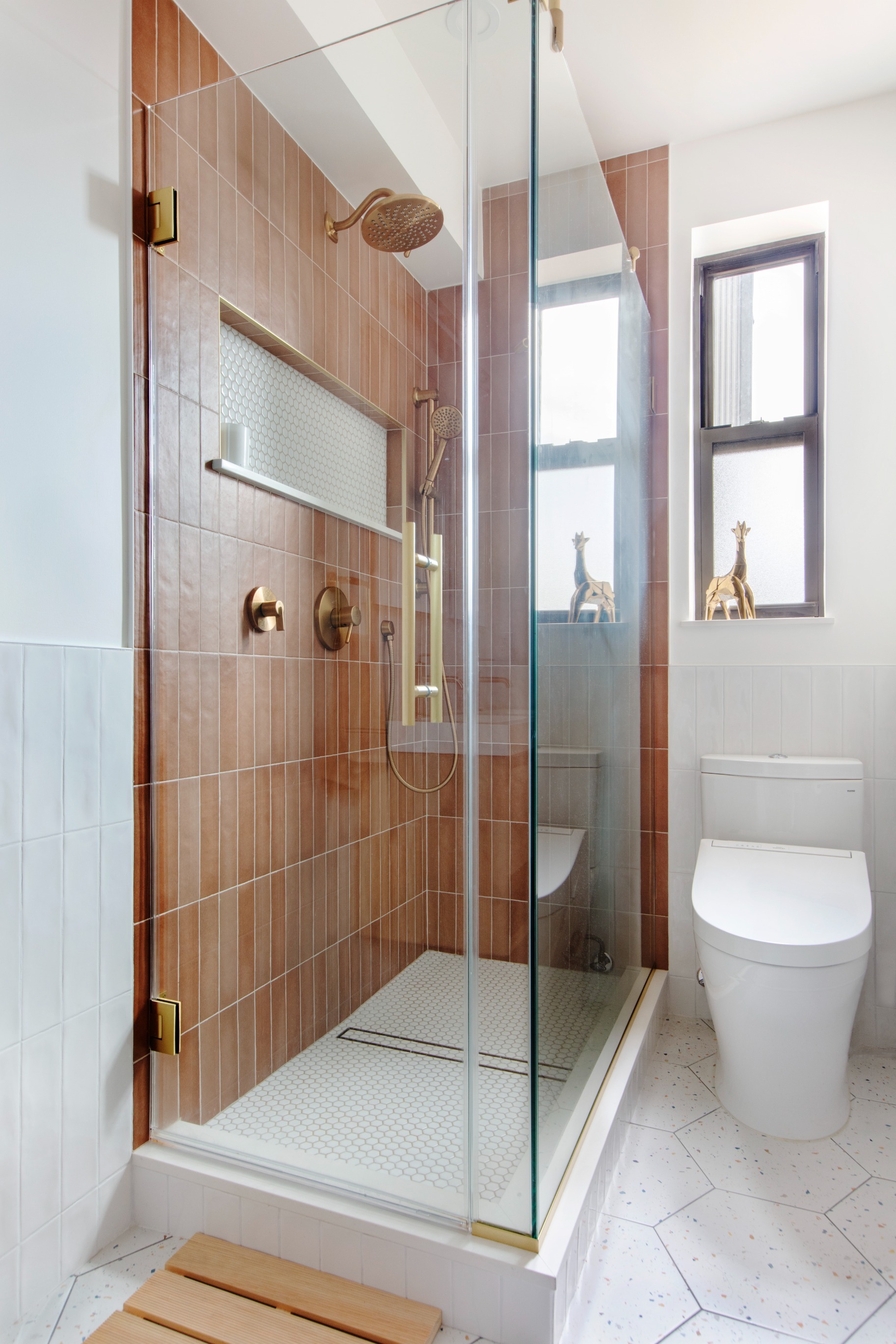

A Queens condo shows what the full-remodel version costs in an expensive market. The homeowners replaced a cramped, dated bathroom with a terracotta-tiled walk-in shower in place of the tub, a double vanity sized for two people getting ready at once, and a washlet toilet. The finished bathroom came to $31,400 over a five-week build. See the the tub to shower conversion completed by Art Deco Enterprises.

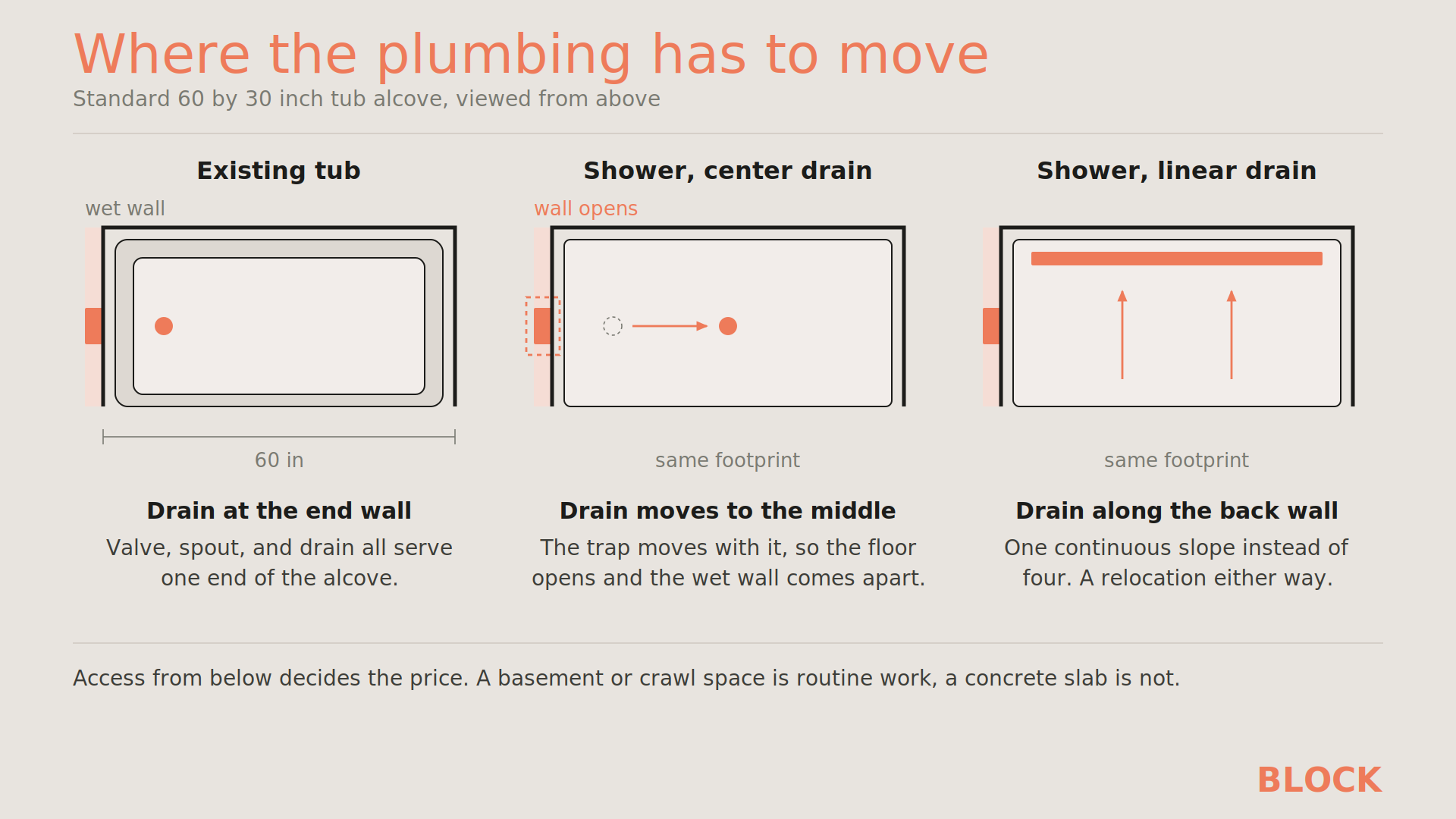

Pull a tub out and the drain is suddenly in the wrong place. A tub drain sits at one end of the alcove, while most shower drains go near the center of the pan, or along one wall for a linear drain, so relocating it means opening the floor to reach the trap. With a basement or crawl space underneath, that is routine. Over a concrete slab, or in a condo where the ceiling below belongs to a neighbor, it becomes a design constraint instead.
The valve comes out too. A tub-and-shower valve carries a diverter and a drop to the spout, and neither does any work in a shower-only setup, so the wet wall gets opened. Crews often find old galvanized supply, a rotted stud bay, or a slow leak the tub surround had covered.
Then the waterproofing gets rebuilt from nothing. Tile is not waterproof, so a tiled shower needs a membrane system behind it and a pan built to slope. The tub it replaced did that job by itself. Homeowners cut this line when a quote comes in high, and it is also the repair that means tearing the tile back off.
Ask what your quote assumes about the drain and the valve, and what happens if the wall opens on something unexpected. Rerouting plumbing is the most common reason a conversion goes over estimate.

A standard alcove tub measures 60 inches long and 30 or 32 inches deep. That opening takes a 60x30 or 60x32 shower base with no framing changes at all, and the alcove conversion is the cheapest version of this project for exactly that reason. Older houses turn up 54-inch tubs and other odd widths. Reframing the opening to fit a stock base is minor work, not a red flag.
Here's the thing that surprises a lot of homeowners: you will not gain floor space. The footprint measures the same before and after. You get a clear sightline where a tub apron and a shower curtain used to block one, and no rim to step over on the way in. Both are worth having. Should you need the room itself to be bigger, that becomes a bathroom layout question.
Ask for a curbless shower after the framing is up and the crew has to undo work you already paid for.
A curb is a low tiled lip at the entry that contains water reliably for very little money, and it is what most conversions get. Going curbless puts the shower floor flush with the bathroom floor, so the shower floor has to drop in order to create slope. Either the subfloor gets recessed between the joists or the rest of the bathroom floor gets built up.
The slope needs to reach roughly a quarter inch per foot toward the drain, and the waterproofing membrane has to extend past the shower onto the bathroom floor, since no curb is there as a second line of defense. Expect curbless to add $800 to $2,500 over a curbed build, plus time on the schedule.

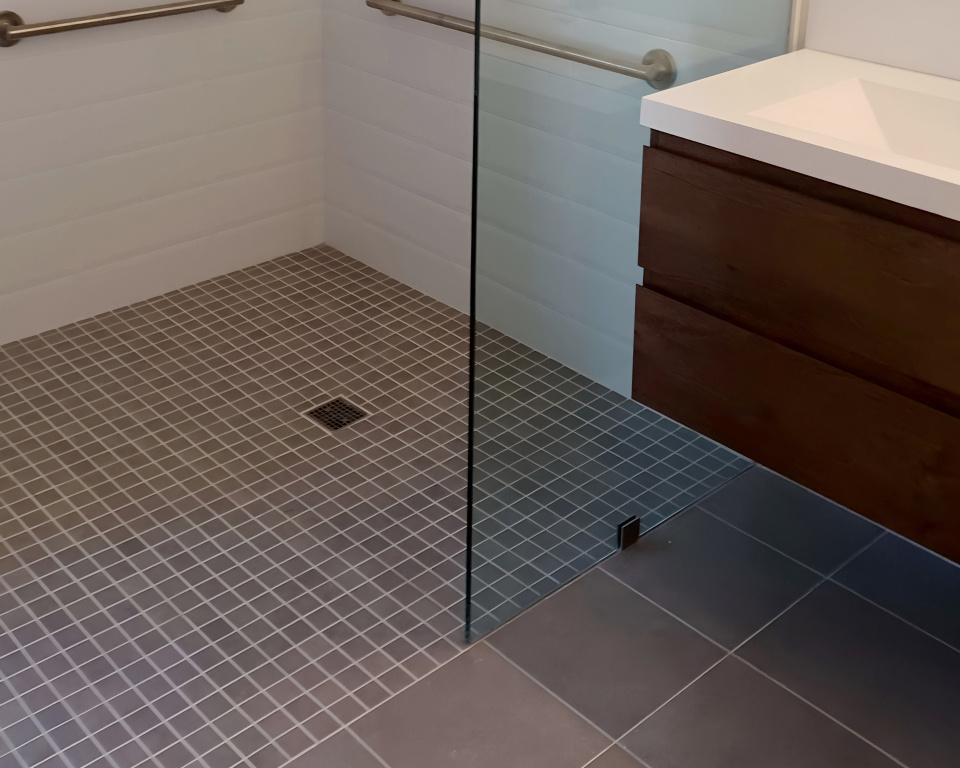

Shallow joists, a concrete slab, or a condo board can each rule it out, so raise it at the site visit. Curbless is the right call for wheelchair access and aging in place, and it is the only entry a wheelchair can roll straight into. A low-threshold shower gets you most of the open feel without the subfloor work.

The base, the tile, and the glass are where you have real control over the cost of your tub-to-shower conversion.
Should the rest of the bathroom come out at the same time? With a floor, vanity, and toilet in good shape, a standalone conversion is the cheaper path and you are done inside a week or two. You will be looking at a new shower next to an older floor, and a visible threshold where the two tiles meet.
Fold the conversion into a full bathroom remodel when:
Stay standalone when the rest of the bathroom is recent, or when the budget calls for phasing. Converting now and redoing the floor in two years works fine, as long as your contractor knows the plan and builds the threshold detail for it.
Build your tub-to-shower conversion schedule around the glass order. Everything else follows a predictable sequence, and the glass does not.
Those are build times. And that's before you get to design, material lead times, and permit review, all of which routinely take longer than the construction itself.
| Task | Timeline estimate |
|---|---|
| Tub demolition and haul-out | 1 to 2 days |
| Plumbing adjustments | 2 to 3 days, more if the wall opens on a problem |
| Framing and backer board | 1 to 2 days |
| Waterproofing and pan build | 2 to 3 days, plus cure time |
| Tile setting and grout | 3 to 5 days for a standard alcove |
| Glass measure and install | 1 day, roughly 2 weeks after templating |
| Fixtures and finishes | 1 to 2 days |
Glass gets templated only after the tile is set, then fabricated, so plan on about two weeks between a finished shower and a usable one. Ask early whether your contractor will hang a temporary curtain rod.
| 🚩 Red flag. Be skeptical of any contractor who promises a full tub to shower conversion in a couple of days. It is a tempting quote and it does not describe quality work at this scope. A turnaround that fast means a rip-and-replace with no time to inspect for damage, rebuild waterproofing, or let anything cure. |
Blocking behind the tile costs almost nothing during framing and saves a great deal later, and the same holds for most of the accessibility work on this list.
A shower puts far more steam into a room than a tub does, and the fan sized for the old bathroom usually cannot keep up with the new one. Plan on 1 CFM per square foot for a bathroom under 100 square feet, more with a high ceiling or a fully enclosed shower, vented to the exterior rather than into an attic.
What should you have answered before a contract gets signed? These, at minimum:
A tub to shower conversion hides more work behind the wall than almost any other single-fixture project, and the contractor you pick determines whether that work gets done properly or gets covered up. Block Renovation matches you with vetted local contractors who compete for your project against a scope reviewed by experts, so missing line items and red flags surface before construction rather than during it. Payments run through Block and release as the work progresses, and every contractor in the network provides a one-year workmanship warranty.
Remodel with confidence through Block
Connect to vetted local contractors
We only work with top-tier, thoroughly vetted contractors
Get expert guidance
Our project planners offer expert advice, scope review, and ongoing support as needed
Enjoy peace of mind throughout your renovation
Secure payment system puts you in control and protects your remodel
Written by Tenzin Dhondup
Tenzin Dhondup
Can I convert any bathtub to a shower?
In most cases, you should be able to convert your bathtub to a shower. Here are some considerations before you commit to a tub to shower conversion:
What is the best type of shower to install in place of a bathtub?
Can I do a bathtub to shower conversion myself, or should I hire a professional?
What kind of maintenance is required after converting a bathtub to a shower?
Are there any accessibility considerations for bathtub to shower conversions?
Will converting my bathtub to a shower affect my home’s resale value?
What materials are best for a durable and attractive shower?
How can I ensure proper drainage in my new shower?
What design options are available for a tub to shower conversion?
Renovate confidently with Block
